PF-ENG-SOLAR-HUB-001 · v1.1
Download PDF Download HTML Back to page

Precifarm

Electric mobility infrastructure for Africa

PF-ENG-SOLAR-HUB-001 · v1.1

Engineering package

Solar Chargers & Charging Stations

Design basis and engineering task sheet for Precifarm route hubs, campus stations and private house hybrid charging.

Document ID: PF-ENG-SOLAR-HUB-001
Version: 1.1 · 16 August 2026
Owner: Precifarm Engineering
Status: Concept / feasibility reference — not a construction drawing set
Contact: sales@precifarm.com · +254 794 702 768
Construction requires site surveys, Kenya Power connection studies, licensed Kenyan electrical design, and statutory approvals. Figures and costs are planning assumptions unless labelled otherwise. Solar and storage optimise cost and resilience; they do not replace a feeder study or a contracted demand case.

1. Purpose

This package is the engineering design basis and single-site delivery task sheet for Precifarm solar-assisted DC charging stations.

TypeRoleTypical user
Route charging hubReserved CCS2 windows for scheduled electric buses on Nairobi–KisumuPartner operator + Precifarm ops
Private campus / in-houseMulti-pedestal AC/DC on private landHost organisation
Private house hybridCharger on the customer meter; optional rooftop solar + storageHomeowner / estate

Governing design principles

2. System concept

Kenya Power (grid) → MV/LV transformer → site LV board (import limit) ↑ PV inverter / hybrid PCS ← solar canopy PV │ LiFePO₄ BESS → DC EVSE (CCS2) → electric bus │ edge gateway — OCPP 2.0.1 → CSMS (Modbus: meter, inverter, BMS)

Dispatch order at the edge (cloud is advisory):

  1. Electrical safety, emergency stop, insulation and thermal interlocks
  2. Declared site import limit (utility + transformer + switchboard)
  3. Reserved bus windows (timetable energy before public or opportunistic load)
  4. Tariff / demand-charge reduction
  5. Solar self-consumption and BESS state-of-charge floors
LayerFunction
Energy supplyGrid import + canopy/rooftop PV + optional LiFePO₄ storage
Fast chargingModular CCS2 DC (120–180 kW town/bus · 240–320 kW highway class)
Civil / canopyWeather protection, PV mounting, bus approach, queue, dwell
OperationsOCPP 2.0.1 sessions, metering, reserved windows, remote monitoring
Route charging hub with solar canopy, DC chargers, battery storage and electric bus
Figure 1 — Route hub concept: solar canopy, DC dispensers, storage cabinets, electric bus.

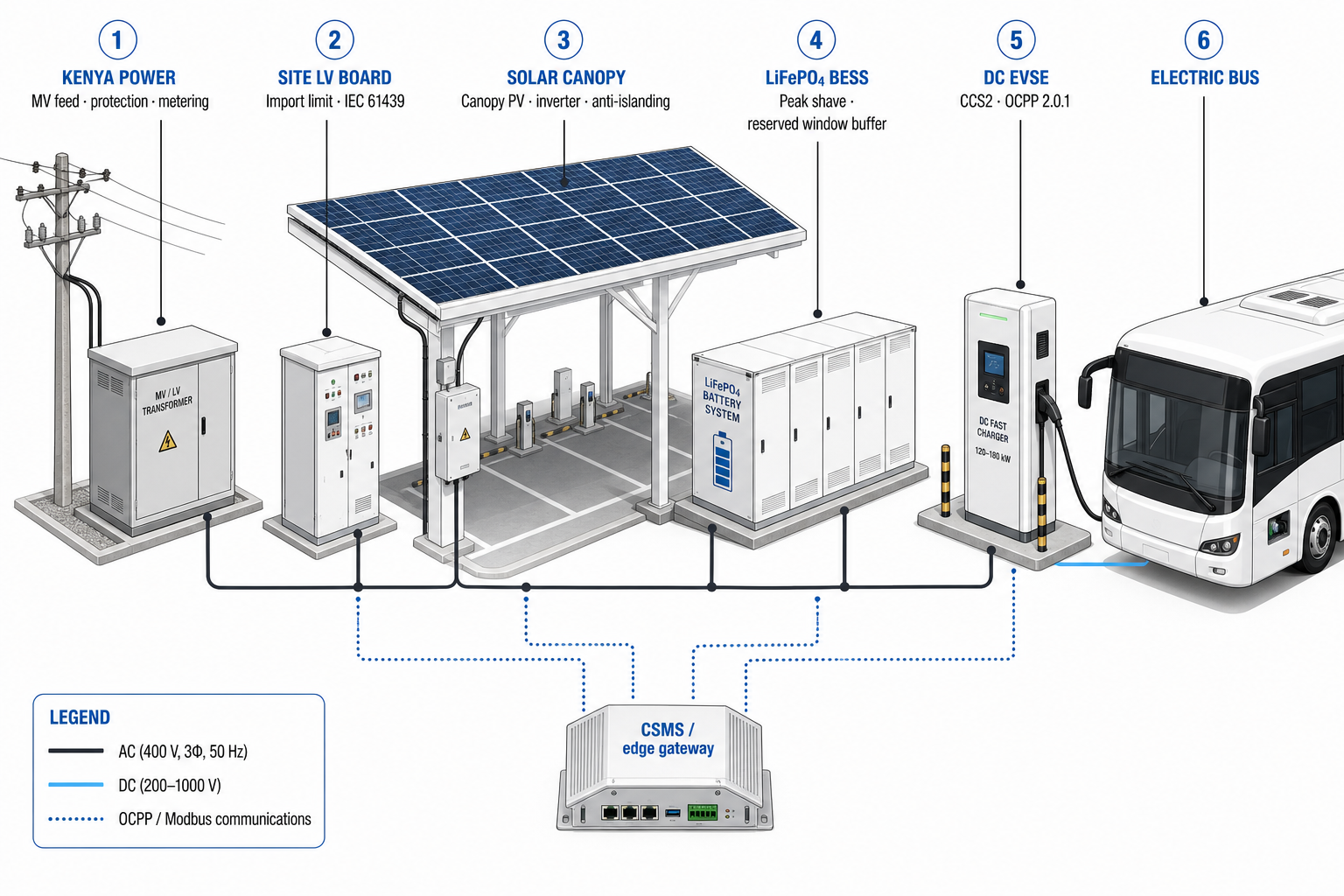

System architecture diagram of Kenya Power, solar, storage, CCS2 charger and CSMS
Figure 2 — System architecture: Kenya Power · canopy PV · LiFePO₄ · CCS2 DC · OCPP edge / CSMS.

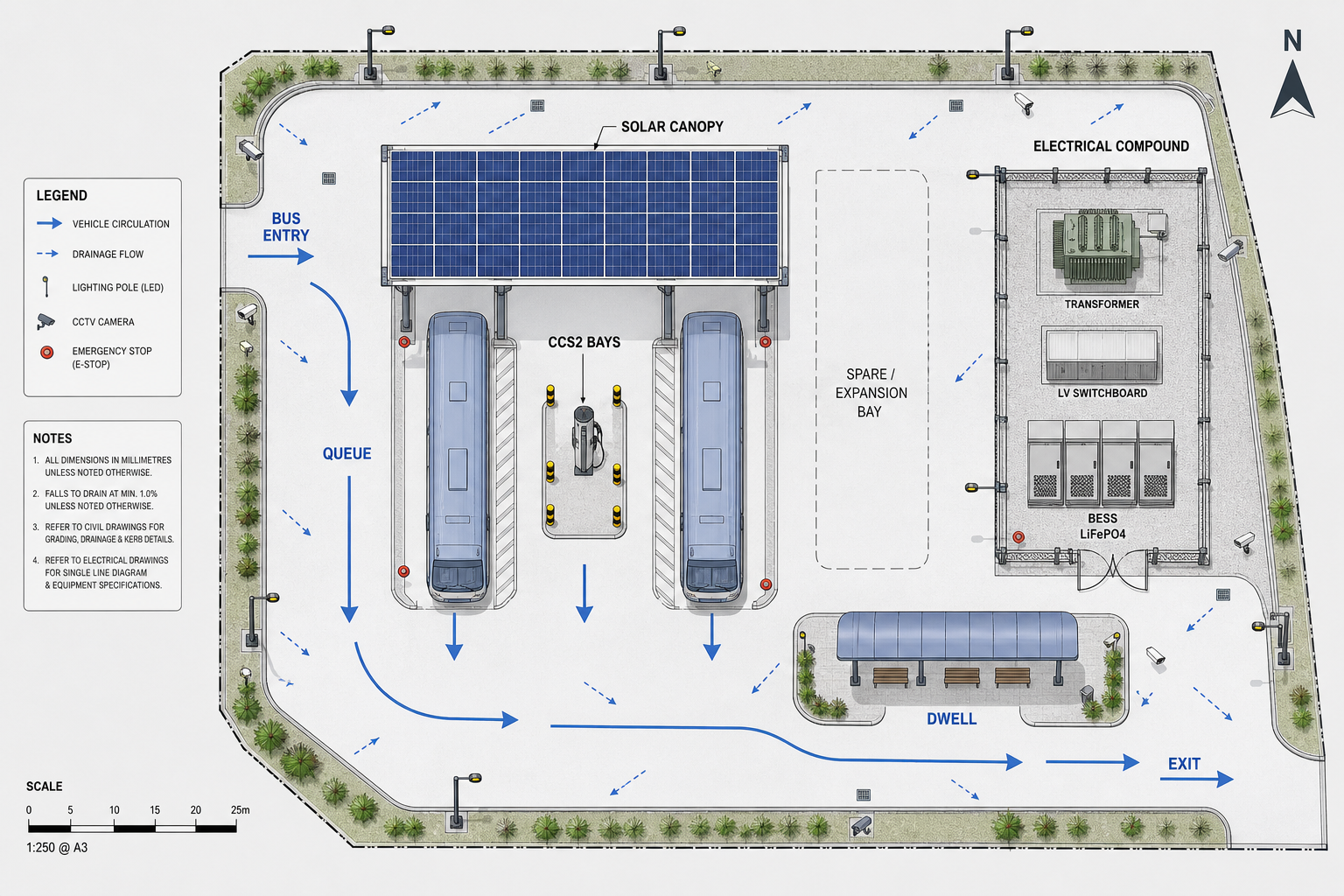

Typical two-bay route hub site plan
Figure 3 — Typical two-bay route hub plan: one-way bus circulation, solar canopy, separated electrical compound, dwell, expansion bay. Illustrative — not a surveyed layout.
Private house hybrid EV charging with rooftop solar and wall charger
Figure 4 — Private house hybrid: grid + rooftop solar + wall charger + home storage.

2.1 Photo annex — stations, sites and vehicles

Additional reference imagery used across Precifarm charging surfaces. Illustrative — not as-built photography.

Intercity route charging hub with solar canopy and electric bus at DC charger
Figure 5 — Route charging hub (marketing reference): solar canopy, DC fast charger, electric bus.
Premium Kenyan EV charging hub at golden hour with solar canopy
Figure 6 — Premium corridor hub concept in Kenya landscape context.
Private campus charging station with multiple pedestals under solar canopy
Figure 7 — Private in-house / campus station: multi-pedestal solar canopy site.
Private house hybrid EV charging with solar and battery storage
Figure 8 — Private house hybrid install: wall charger, rooftop solar, home storage.
Residential home EV charging installation
Figure 9 — Residential charging reference install.
Yutong U18 electric intercity bus
Figure 10 — Yutong U18 electric intercity bus (route vehicle reference).
Yutong U12 electric city bus
Figure 11 — Yutong U12 electric city bus (fleet / urban reference).
Precifarm electric bus on route
Figure 12 — Electric bus on corridor service (brand reference).

3. Design basis — route charging hub

3.1 Functional requirements

IDRequirement
R-01Deliver reserved CCS2 DC energy so scheduled electric buses leave on timetable
R-02Prefer Type 2 (AC) / CCS2 (DC) as Kenya public defaults
R-03Modular shared-power cabinets; expand only against contracted demand
R-04Integrate solar canopy where irradiance and structure allow
R-05LiFePO₄ storage for peak shaving / weak-grid resilience (site-dependent)
R-06OCPP 2.0.1 to CSMS; durable edge queue for offline recovery
R-07First-attempt charge success and delivered kWh as primary KPIs
R-08At least two operational DC ports at a corridor hub so one fault does not strand the route
R-09Hard site-import clip from local metering — cloud setpoints cannot exceed the utility envelope
R-10Identify the coach, start the reserved session, and write a metered session record for settlement

3.2 Nairobi–Kisumu site classes (planning)

Route one is Nairobi–Kisumu (~345 km, ~4 h 45 m). Hubs exist to protect the timetable.

Site classPlanning roleTypical dwellEquipment class
Nairobi depot / terminusOvernight and pre-departure top-upHours (managed)120–180 kW DC + 11–22 kW AC
En-route (e.g. Nakuru)Opportunity charge if remaining range is insufficient20–40 min120–180 kW; 240–320 kW if dwell is shorter
Kisumu terminusArrival recovery + next-day readinessHours / overnight120–180 kW DC + AC as dwell allows

3.3 Energy model (planning assumption)

ParameterPlanning valueNote
Specific consumption1.2 kWh/km loadedReplace with OEM / loaded test
Route distance~345 kmNairobi–Kisumu
Trip energy~414 kWh1.2 × 345
Beachhead departures5/dayCanon planning assumption
Mid-route opportunity charge80–150 kWh20–40 min at 150–180 kW usable

Worked example — one reserved window (illustrative): 120 kWh in 30 min → 240 kW at the vehicle. At 95% charger efficiency, AC input ≈ 253 kW. If the Kenya Power import limit is 180 kW, BESS must cover the gap: (253 − 180) × 0.5 ≈ 37 kWh plus reserve → usable BESS typically ≥ 80–100 kWh for that window.

A 40–80 kWp canopy in Kenya yields roughly 180–440 kWh/day. Against a 1,500 kWh/day hub, PV covers on the order of 12–30% of daily energy. Use it for cost, shade and resilience — not as a substitute for the feeder.

3.4 Typical equipment class (planning)

ElementPlanning classNotes
DC dispenser120–180 kW (town/bus) · 240–320 kW (highway)RFQ against Chinese charger shortlist
ArchitectureModular shared-power preferredAdd cabinets against utilisation
ConnectorCCS2 dual-port at corridor hubsCHAdeMO/GB/T only if fleet-specific
PV canopy40–80 kWp typical two-bayExport only with written utility approval
BESSLiFePO₄, 100–250 kWh usable first siteDispatch under import limit; fire separation
TransformerConcept 315–500 kVA after diversitySite study required
CommunicationsDual path at critical hubsEthernet + cellular

3.5 Solar canopy sizing method

  1. Structure first — canopy area is set by bus geometry, wind and seismic.
  2. Module packing — planning ~160–200 Wp per m² of canopy plan area.
  3. Yield — Kenya planning 4.5–5.5 kWh/kWp/day (site PVsyst later).
  4. Self-consume into BESS and site load; export only if the connection offer allows it.
  5. Anti-islanding — inverter/PCS trip on loss of mains.

Illustrative two-bay canopy: 12 m × 24 m ≈ 288 m² → ~50 kWp → ~225–275 kWh/day.

3.6 BESS sizing method

Size storage to the binding constraint, then take the larger of: reserved-window gap, peak-shave to an affordable kVA, ride-through for one abort/restart, and SoC floors for the next contracted window. Chemistry: LiFePO₄ outdoor cabinets.

3.7 Electrical design checklist

Item
Kenya Power connection study and declared POC voltage (LV or MV)
15-minute load profile: reserved windows, public, auxiliaries, PV, BESS
Transformer / switchboard sizing (IEC 61439 / 60947)
Cable ampacity, voltage drop, fault withstand
Protection coordination; Type B RCD / RDC-DD as required
Earthing, bonding, touch/step voltage
Lightning risk (IEC 62305) and coordinated SPDs
Harmonics, PF, flicker; PV/BESS anti-islanding and export approval
Thermal management for high-power DC cabinets
Emergency stop, isolation, and responder access independent of software

3.8 Civil & site checklist

Item
Safe entry/exit and queue storage for 12 m-class buses (drive-through preferred)
Dispenser clearances, impact protection, cable management
Canopy wind/seismic loads; PV mounting integrity
Separated transformer, switchgear, charger and BESS compounds
Drainage away from energized equipment; lighting, CCTV, fire access
Passenger dwell offset from the electrical compound
Spare ducts, foundations and switchboard ways for one expansion bay

4. Design basis — private campus / in-house station

IDRequirement
C-01Start from vehicle count, arrival SOC and dwell — not from a brochure kW
C-02Prefer 11–22 kW Type 2 AC where vehicles park for hours; add DC only for short dwell
C-03Building / estate import limit and landlord earthing govern charger count
C-04Submetering for the host; OCPP if revenue-bearing or fleet-managed
C-05Optional canopy PV + LiFePO₄ using the same sizing methods as route hubs
C-06Fire access, impact protection and isolation — campus does not mean light duty

5. Design basis — private house hybrid

IDRequirement
H-01Charger on customer property and meter — not a public hub
H-02Start from duty cycle: typically 7.4 kW AC; DC only when justified
H-03Optional solar + storage for overnight resilience
H-04Same engineering discipline: survey, install, commissioning, support
H-05App visibility for personal home charging when product supports it
H-06Type A 30 mA plus 6 mA RDC-DD, or Type B, on a dedicated final circuit

6. Software & cybersecurity (station)

TopicBaseline
Charger protocolOCPP 2.0.1 (greenfield)
Upgrade pathOCPP 2.1 / ISO 15118-20
EdgeOffline auth snapshot, durable session queue, local load management
CloudSessions, billing hooks, fleet windows, OTA, fault management
SecuritySegmented OT/IT, least privilege, signed firmware
SafetySoftware cannot override hardware E-stop, insulation monitoring, or import-limit trip

7. Kenya approvals and hold points

Hold capital and equipment orders until these are in the site pack (or explicitly waived in writing).

GateOwnerEvidence
Contracted demandCommercialOperator window / kWh commitment
Site controlCommercial + legalHost agreement, tenure, access
Kenya Power enquiryElectricalFeasibility / connection offer, tariff, export rules
Licensed designEBK-registered engineerSLD, protection, earthing
EPRA / Energy ActPMCharging-infrastructure guideline checklist
NEMA / EIAHSEScreening decision or licence as triggered
County / fireCivil + HSEBuilding, fire, BESS separation
KEBS / IEC equipmentProcurementCertificates matching the shipped SKU
CommissioningField + softwareAcceptance tests signed

8. Engineering task sheet

Delivery tracker for a single site. Checkboxes are hold points.

Phase A — Feasibility

IDTaskOwnerOutput
A-01Confirm contracted demand / duty cycleCommercial + EngDemand note
A-02Site walkover, photos, access, host constraintsField engSite pack
A-03Grid enquiry / connection study requestElectricalUtility letter
A-04Concept single-line diagramElectricalSLD v0
A-05Concept layout (canopy, pedestals, storage, circulation)Civil + EngLayout v0
A-06Capex/opex planning estimateEng + FinanceCost sheet
A-07Capital gate: demand + site control + feeder pathPMGo / no-go

Phase B — Design

IDTaskOwnerOutput
B-01Detailed SLD and protection scheduleLicensed electricalIFC pack
B-02Cable schedule and earthing designElectricalSchedules
B-03Canopy / PV structural designStructuralCalcs + drawings
B-04BESS integration and fire separationElectrical + HSESpec
B-05CSMS / OCPP configuration sheetSoftwareConfig pack
B-06Civil drainage, lighting, CCTVCivilDrawings
B-07Statutory submissionsPMApprovals log

Phase C — Procurement

IDTaskOwnerOutput
C-01RFQ against shortlist (bus/highway or house class)ProcurementVendor bids
C-02Factory acceptance criteria + OCPP live testEng + SoftwareFAT checklist
C-03Spares, warranty, local labour, ten-year partsProcurementContract
C-04Confirm Kenya SKU: CCS2, 50 Hz, OCPP 2.0.1, environmental ratingEngConformity matrix

Phase D — Construction & commission

IDTaskOwnerOutput
D-01Civil and canopy installContractorAs-built
D-02Electrical install and torque recordsContractorQA pack
D-03Charger / BESS / PV commissioningField engCommission report
D-04OCPP end-to-end session testSoftware + FieldTest log
D-05Peak-load test against declared import limitElectricalTest sheet
D-06Safety sign-off and handoverPM + HSEHandover certificate
D-07Operator training (T1–T3 as applicable)TrainingAttendance

Phase E — Operate

IDTaskOwnerOutput
E-01Reserved window calendar liveOpsSchedule
E-02Uptime and delivered-kWh dashboardOpsKPI weekly
E-03Preventive maintenance planFieldPM calendar
E-04Incident / exception processOpsRunbook
E-05Utilisation review before next cabinet / portEng + FinanceExpansion note

9. Acceptance criteria (route hub)

A site is engineering-accepted when:

  1. Documented connection agreement and site import limit are respected under peak test load
  2. At least one successful CCS2 session delivers metered energy to a representative vehicle
  3. A reserved-window rehearsal completes the contracted kWh inside the timetable (or a documented exception path is proven)
  4. OCPP session and meter values reconcile in CSMS
  5. Emergency stop, isolation, and earthing verification are signed
  6. PV anti-islanding and BESS fire/separation checks are signed where those systems are installed
  7. As-built SLD and O&M pack are filed

Engineering acceptance is necessary; it is not traction. Commercial live-route proof remains a separate Canon proof gate.

10. Related references
